Surf District Gateway Signage: Creating an Icon While Minimizing Risk

Surf District in Clear Lake, Iowa, is more than a destination—it’s a cultural landmark built around music history, community pride, and placemaking. Anchored by the historic Surf Ballroom—where Buddy Holly played his final show—the district is recognized as an Iowa Great Place and continues to evolve as a year-round hub for residents and visitors alike.

As part of that evolution, the City of Clear Lake envisioned a bold gateway sign to announce entry into the Surf District while honoring its legacy. The goal was a landmark moment—something iconic, durable, and worthy of the place it represents.

Latitude was brought in early to collaborate with Dean Snyder Construction and the City to translate that vision into a sign that could actually be built, installed, and maintained—without introducing unnecessary risk.

The Challenge: When Concept Meets Reality

The original concept provided to our team centered on a dramatic, double-sided illuminated logo mounted to a 12-foot-diameter steel plate. Visually, it was compelling.
Practically, it raised red flags like:

  • The half-inch steel plate weighed an estimated 700–800 pounds

  • Installation would require a crane and full road closures

  • Any future service work meant removing the entire plate to access wiring (still 700-800 pounds)

  • The logo geometry itself posed fabrication and mounting challenges at scale

Left unresolved, these issues would increase installation complexity, cost, safety exposure, and long-term maintenance risk.

The Approach: Reduce Risks, Keep Design Intent

Rather than forcing the original concept into production, Zach Story, Project Manager at Latitude, raised concerns about fabrication and installation with the original design. From here, the project team worked to solve the how—not the why—behind the sign.

Key decisions included:

  • Refining the logo into a more fabrication-friendly mark that stayed true to the Surf District brand

  • Replacing the steel plate with a custom, shallow aluminum cabinet—just one inch deep

  • Designing for serviceability, allowing all wiring to be completed in the shop prior to installation

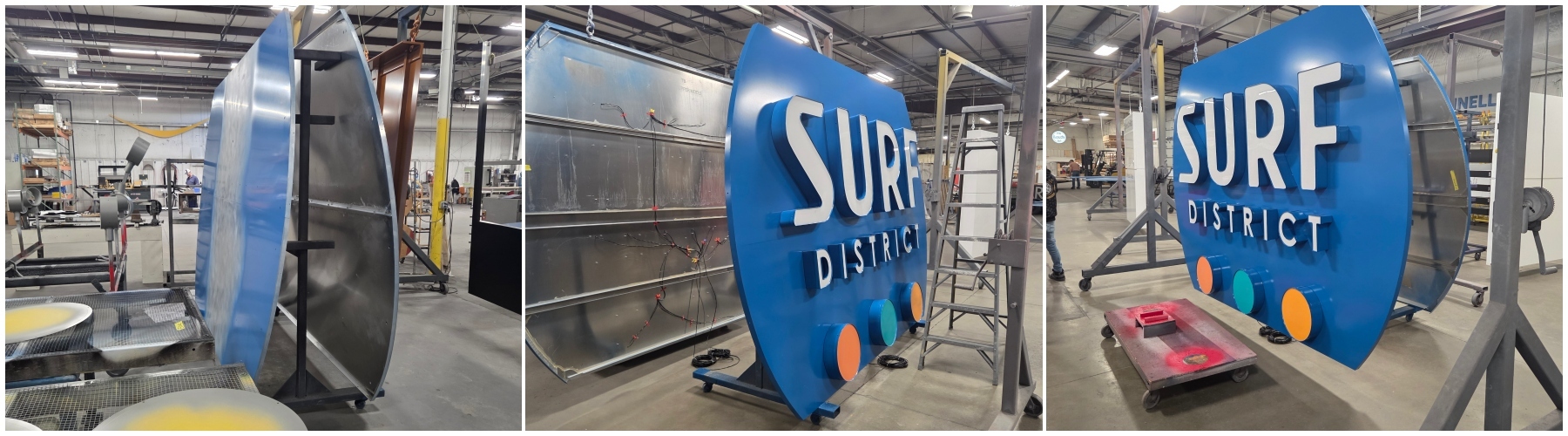

    The result was a dramatically lighter structure that could be installed with a boom truck instead of a crane—reducing road closures, improving safety, and simplifying future maintenance. To further manage risk and logistics, the cabinet and logo were fabricated in four sections, fully pre-wired, and delivered with primary elements already attached.

Sign Installation Under Real-World Constraints — Iowa Winter

Installation didn’t happen under ideal conditions—and that’s where the redesign paid off.

Weather and traffic limitations shortened the initial installation window, allowing only the main cabinet to be set on the first trip. Thanks to the reduced weight and simplified mounting strategy, that phase was completed smoothly and efficiently.

A follow-up visit addressed the remaining elements:

  • Installation of 14-inch-tall letters mounted directly to a structural steel beam

  • Single-lane closures instead of full shutdowns

  • Cold-weather drilling was planned and executed with precision

Winter added one more curveball when snow and ice entered an uncovered access panel, freezing the conduit and temporarily preventing illumination. Latitude coordinated closely with the general contractor on a return visit to safely thaw the conduit and complete final connections—without damaging components or finishes.

What's Next?

In addition to the primary gateway sign, three exterior-grade graphic pylon signs honoring Buddy Holly, Ritchie Valens, and the Big Bopper have been fabricated. Installation is scheduled for spring, following completion of adjacent masonry work.


The Result: A Landmark Built to Last

The Surf District gateway sign delivers the visual impact the City envisioned—while quietly solving the problems that could have followed it for decades.

By challenging assumptions early, designing with fabrication and installation in mind, and staying closely aligned with the project team, Latitude helped:

  • Reduce installation and maintenance risk

  • Improve long-term serviceability

  • Preserve design intent without compromise

  • Keep schedules and logistics manageable

The finished sign now stands as a clear, confident welcome to Clear Lake’s music-driven district—and as proof that the best signage solutions are built on collaboration, foresight, and real-world experience.

Have questions about this project or facing challenges on your project? Let’s connect early and reduce that risk.
